The Towards Net Zero Carbon Emission for the Imaginary Country of Kanjaba Case Study represents a comprehensive examination of how strategic project management and public awareness initiatives can drive environmental sustainability. This case study demonstrates the practical application of structured project management methodologies in addressing one of the most pressing global challenges: reducing carbon emissions to achieve net-zero targets. By analyzing the electric vehicle (EV) awareness program implemented in Kanjaba, this case study provides valuable insights into stakeholder engagement, resource allocation, risk mitigation, and the critical role of government support in transitioning a nation toward sustainable transportation infrastructure. The initiative serves as a benchmark for understanding how developing nations can leverage awareness campaigns, community participation, and strategic planning to foster behavioural change among citizens while simultaneously contributing to international climate goals. Through examining the project's timeline, budget allocation, deliverables, and lessons learnt, this Towards Net Zero Carbon Emission for an imaginary country of Kanjaba case study illustrates the multifaceted approach required to successfully transition populations from conventional vehicles to electric alternatives, thereby reducing environmental impact and improving overall quality of life.This case study is particularly valuable for assignment help seekers, students, and professionals looking to understand real-world applications of project management principles, environmental sustainability strategies, and stakeholder management in the context of achieving net-zero carbon emission goals.
To establish awareness program as to increase the use of Electric vehicles (EV) within Kanjaba for achieving goal of net zero carbon emission.
The project charters for increasing use of EV vehicles are as follows:
| PROJECT CHARTER | ||
|---|---|---|
| Project Title: Increasing use of Electric vehicles | Project Manager | |
| Project Start Date | Project end date | Project sponsor: Government |
| 28 August 2024 | 20 Feb 2025 | |
| Business needs | ||
| Project scope | Deliverables | |
| To motivate all the individual of Kanjaba to shift towards electric vehicles | This project will help in creating interest of country’s population towards EV. This will aid in reducing carbon emission and support in improving country’s environment. | |
| Financial | ||
| Budget | £ 35000 | |
| Milestone Schedule | ||
| Target completion date | 19 December 2024 | |
| Actual completion date | 24 December 2024 | |

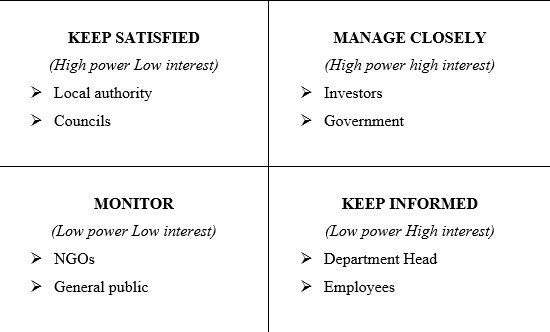

Following stakeholder matrix indicates the individual that are interested in the working of the project and have power to control operations:

It has been determined that local authority and councils are not interested the working of the program but has huge power to control operations. They are involved in ensuring that no illegal activities has been undertaken and has right to change the decision. Government and investors are highly involved in the project as they are interested to identify the accurate return (Alizadehsalehi and Yitmen, 2023). Government need to ensure that program is creating positive impact on the environment. Further NGOs and general public has neither right to take decision nor interested in the working of the program. Department head and employees are interested in ensuring that adequate amount of returns are generated but does not have power to take decision.
Following table describes the total budget that will be required for the establishing an EV awareness program:
| Activities | Amount (in GBP) |
| Physical resources | 9000 |
| Human resources | 5000 |
| Technical expenses | 7000 |
| Administrative expenses | 5000 |
| Marketing and promotional expense | 9000 |
| Total | 35000 |
Timeline:
| S. No | Task Name | Duration | Start | Finish | Predecessors |
| 1 | Setting outline | 10 days | Wed 8/28/24 | Tue 9/10/24 | |
| 2 | Determining resources | 15 days | Wed 9/11/24 | Tue 10/1/24 | 1 |
| 3 | Segmenting audience | 10 days | Wed 10/2/24 | Tue 10/15/24 | 1,2 |
| 4 | Creating schedule of events | 25 days | Wed 10/16/24 | Tue 11/19/24 | 3 |
| 5 | Formulating action plan | 17 days | Wed 11/20/24 | Thu 12/12/24 | 4 |
| 6 | Identifying partners | 12 days | Fri 12/13/24 | Mon 12/30/24 | 2,5 |
| 7 | Implementing action plan | 16 days | Tue 12/31/24 | Tue 1/21/25 | 5,6 |
| 8 | Evaluating campaign | 5 days | Wed 1/22/25 | Tue 1/28/25 | 7 |
| 9 | Doing changes | 10 days | Wed 1/29/25 | Tue 2/11/25 | 8 |
| 10 | Final execution | 7 days | Wed 2/12/25 | Thu 2/20/25 | 9 |

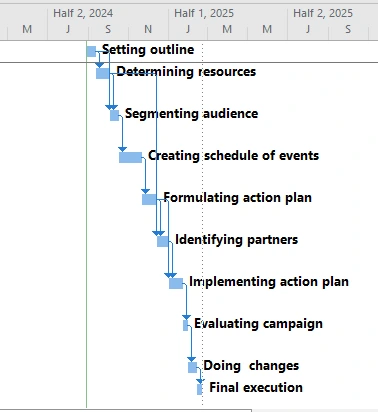

Gantt Chart

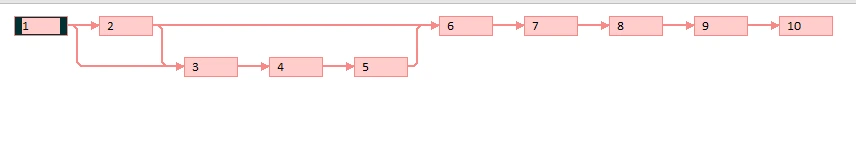

Network Diagram

The various benefits and outcome of the EV project management plan could be understood through the following points:

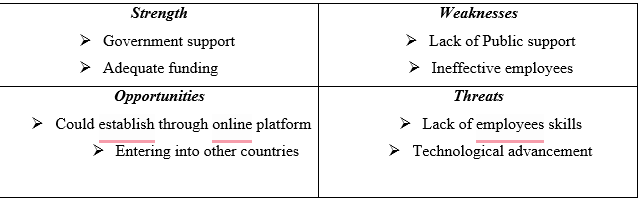

SWOT analysis

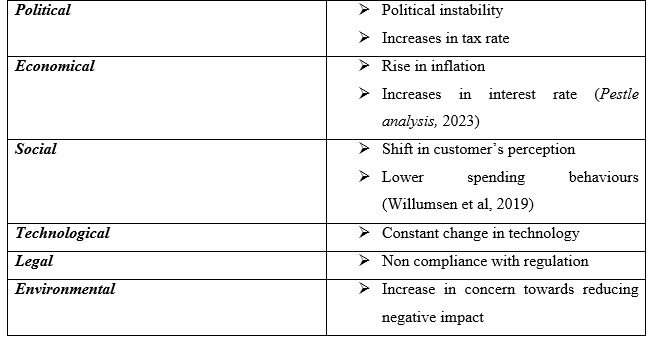

Pestle analysis

Risk analysis
| Risk | Impact | Likelihood | Owner | Strategy to mitigate risk |
| Operational risk | High | Moderate | Operational manager | Benchmarking strategy should be adopted by the manager that will help in determining the deviation by comparing actual outcome with the set standard (Best et al, 2020). |
| Technical risk | Moderate | High | Technological manager | For reducing risk conduct market research will be undertaken that will help in determining changes and support in timely acquiring the new technology. |
| Economic risk | High | Low | Financial manager | Accurate budget will be allotted to each department so that all tasks could be undertaken by prior planning. |
| Resource risk | High | High | Management | Accurate resources analysis should be undertaken as to estimate the need and arranging all the required resources on time (Tereso et al, 2019). |
For effectively understanding the efficiency of the project following evaluation and monitoring technique will be used:
 7 Years |  PhD
  7 Years |  PhD
Benchmarking: Under these techniques, the expected outcome along with the time frame will be set up in the beginning of the project (Cheng et al, 2022). The actual performance will be evaluated on this basis that will help in determining deviations.
Budgetary control: this technique will also be used which help in determining the actual spending in comparison to the budgeted amount. Deviation in the budgetary control indicates over or under utilisation of funds.
Lesson Learnt:
From the Project management plan, my understanding regarding various concept of Project management has enhanced. This helps me in enhancing my knowledge regarding the creation of the time line and support in undertaking risk analysis. This project preparation supports in enhancing my knowledge regarding various factors that impact on the operation of the project and help in determining measure through which such issues could be overcome.
REFERENCES
Books and Journals
Online
Get assistance from our PROFESSIONAL ASSIGNMENT WRITERS to receive 100% assured AI-free and high-quality documents on time, ensuring an A+ grade in all subjects.
Introduction Get expert guidance with Online Assignment Help! We offer plagiarism-free work, timely delivery, and support across...View and Download
Introduction: Project Management for LCCA Relocation: Key Strategies Project management is defined as the process with the help...View and Download
Introduction Trust Rapid Assignment Help for detailed, accurate, and plagiarism-free Assignment Help that caters to your...View and Download
Chapter One: Introduction Students researching post-Covid strategies for non-profit organizations can benefit greatly from...View and Download
Introduction: UHC's Role in Health Rights and SDG3 Promotion Need help with assignments on Universal Health Coverage and...View and Download
Introduction: Organisational Behaviour Get free samples written by our Top-Notch subject experts for taking Online...View and Download
